|
A Guide to Implementing the Theory of Constraints
(TOC) |
|||||
|
Multi-Project Drums |
|
|
|
Comparing Safety In Production & Projects There
are two groups of people who are likely to use these pages on projects; those
with prior knowledge of production operations (manufacturing) and those with
pure project backgrounds. For this
reason I want to compare and contrast between production operations and
project operations. The similarities
are much greater than the differences.
I want to do this for two reasons; 1.
Provide a bridge for people with production
operation experience in order to enter into the project domain. 2.
Show people with project operation experience that
the challenges that they face are not that different from those experienced
in production environments. So I
ask for your indulgence if you already feel slighted that “your” area of
expertise is apparently no more difficult than “their” area of
expertise. You see, we are basically
all in the same boat – and we are all at sea as well. Industrialization is new. We only have to check whether our parents’
generation ran projects or production operations as we do, and if they did,
then check out our grand-parents generation.
The scale and scope of operations today is vastly different from that
of just one or two generations ago.
For instance, just one generation ago we didn’t have computers to make
mistakes quite as quickly as we are able to today. In
fact, computers are now so ubiquitous that we can discuss operations in terms
of the software that drives them, or at least the generic approaches. For production operations the first
software was material requirements planning (mrp or small mrp – referring to
the use of lower case letters).
Material requirements planning allowed the building of bills of
material (BOMs) for a process; a list of all the bits and pieces and maybe
the places where, and the time when, they were required. It wasn’t long before this was beefed up to
materials resources planning (MRP or MRP II) with the addition of capacity
scheduling of each step in the routing that had been used to generate the
bill of materials. More recently this
has been beefed up once again to enterprise resources planning (ERP) where
schedules are wired across functions as well as within functions. Sales and marketing now know what
production is doing and vice versa (well it sounds good doesn’t it?) The
project operations equivalent of the mrp, MRP II, ERP, alphabet soup is
Critical Path Method, (CPM for short).
Critical Path Method tends to be associated with the Gantt charts that
are used to graphically present the relationships between tasks in a project,
but it is generated from an approach called program evaluation and review
technique (or PERT for short). In
fact, as we will soon see, program evaluation and review technique can be
equally applied to production operations as well as to projects. Indeed, maybe PERT is responsible for the
two short comings of both MRP and CPM.
Both approaches assume, even today, that there is more capacity at
each step in a production process, or task of a project, than is actually
required. Colloquially, we tend to
call this “infinite capacity” although we only mean that there is “more than
enough.” Before the advent of
computers when PERT was a manual exercise, this simplification made the
impossible possible. Also,
both MRP and CPM assume that safety is localized throughout the respective
operations. In production operations,
safety is localized in the queuing of product (work-in-process). Each queue represents a safety buffer that
allows late work to catch up to its schedule through the rearrangement of
items or “jobs” in the queue.
Historically, these types of scheduling approaches originated in
so-called job shop environments – places where machinery was likely to be
grouped according to function, rather than the flow-shops that are so much
more common in all but the smallest of facilities today. In Critical Path Method the safety is
localized not in the queue, but within each and every task in the project. Assumptions
of infinite capacity and the localization of safety throughout the operation
are the two aspects that cause so much trouble to modern operations. We won’t address the issues of infinite
capacity assumptions until the next page on Critical Chain Project
Management, because this is an important issue of itself and is to me the
distinction between Critical Chain Project Management and Critical Path
Method. On this page we will address
the issue of localized safety in each step or each task. Essentially we are going to move from
safety that is localized, specific, and everywhere, to safety that is
general, aggregate, and located in just a few critical places. Having
safety “embedded” in each step of a production process or each task of a
project ought, at first pass, seem to be an effective solution. After all you can size each individual
allocation as required – regardless of whether it is explicit within a
production process queue, or implicit within a project task. However, a number of operational and
psychological factors contrive against us.
The operational factors are the dependent nature of serial operations
and the inherent variability that occurs within each operation. The psychological factors are varied, and
probably more important for project-based operations than production-based
operations. We will deal with the
psychological factors as we come to them. In
order to develop the argument for the aggregation and placement of buffers in
project management, I am going to use a PERT diagram for both a production
process and a project. In order to do
that we must make use of the realization that a project is an “A” plant
tipped on its side. Let’s
look at this in more detail. A

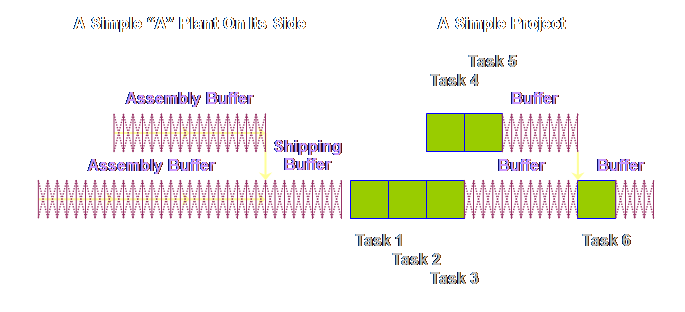

project is an “A” plant tipped on its side (1). This is the “thing” that finally allowed me
to see the relationship between production operations and project operations
and their buffers or safety. But what
is an “A” plant you are asking? Theory
of Constraints sees 4 generic flows in production operations, they are; “V”
plants or divergent plants (divergent from the bottom of the “v” to the top),
“A” plants or convergent plants (convergent from the bottom of the “a” to the
top), “I” plants or linear plants, and “T” plants – a plant with a linear
stem and an explosion of choices at the top (assembly). Each type of plant is typical of particular
operations. “A” plants are typical of
situations where a number of different components from different raw
materials come together to form a final assembly. Let’s

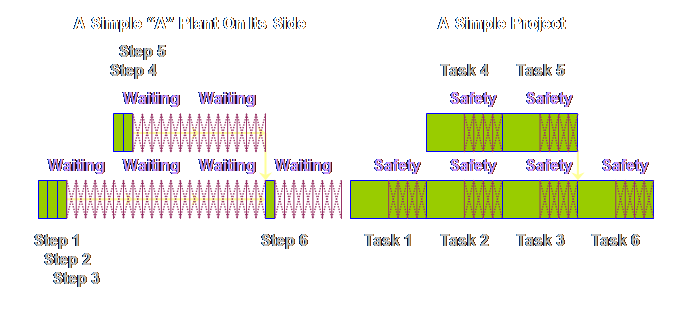

draw a simple, a very simple, “A” plant on its side to see how it would look.
This
type of logic diagram is common in Theory of Constraints. The logic might coincide with the physical
layout of the plant; more often than not, it won’t. For an example of a more complex “A” plant
logic diagram and its corresponding physical layout, have a look at the
diagrams for the P&Q Question. If we
were to draw a very simple project, then apart from some different names, it

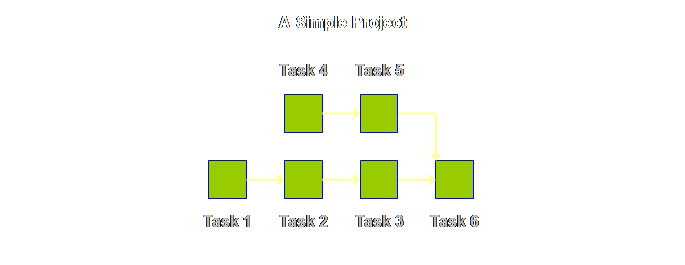

would look exactly the same, lets see.
The
logic diagram for production operations and project operations are exactly
the same, save for different labels.
Let’s put the two diagrams side-by-side.
Let’s

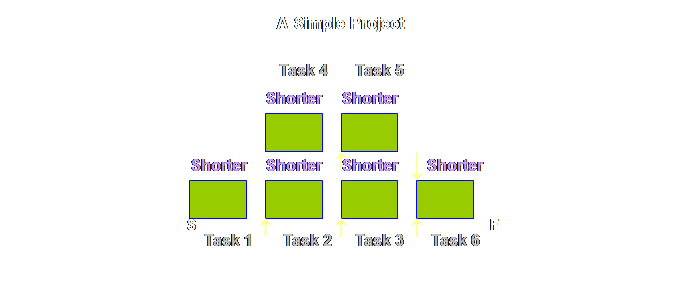

draw each respective diagram so that the steps and tasks are somewhat
proportional to the time taken.
Let’s

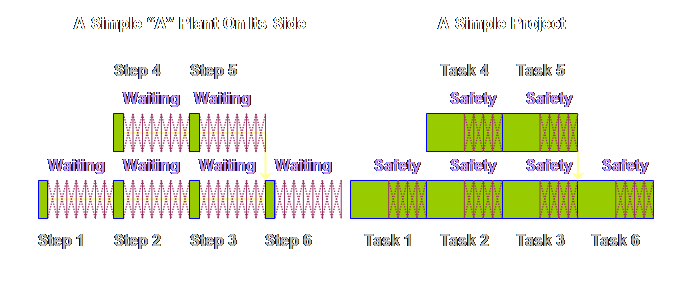

have a look at this waiting in queues.
This
raises a question; there isn’t any waiting in projects – right? Well, not explicitly, and it isn’t called
waiting, it is called safety – “things” in production might wait but people
in projects don’t like to be seen waiting, so we have to call it safety. Let’s
have a look.

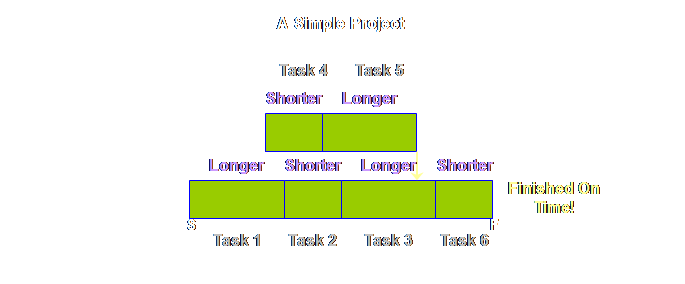

Having
got this far (even if you really don’t think that there is any safety in projects
what-so-ever), we can now show the apparent differences between buffering in
production operations in Theory of Constraints and buffering in project
operations in Theory of Constraints.
If buffering is an unfamiliar concept to you, then please wait a short
while. We need to bury the devil which
says that buffering in the two approaches is different. Once we have done that, then we can start
all over again with the vexed question of why we even have buffers in project
management. Let’s

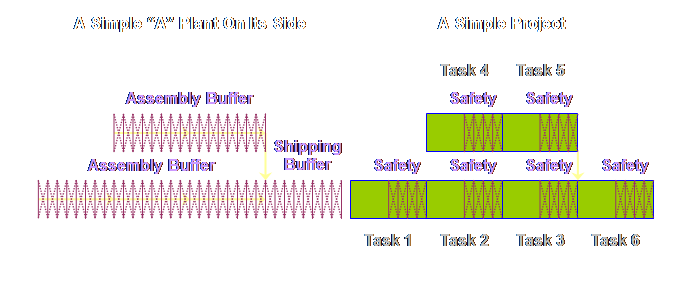

start first with our “A” plant process.
What if we accept that we can move from an MRP schedule to a
drum-buffer-rope (DBR) sequence. In
drum-buffer-rope the only things scheduled are the start and the finish (and
maybe the drum but we will leave that out here). If we accept that, then we can aggregate
the touch time and we can aggregate the waiting time. By aggregating the waiting time we make the
total waiting time available to the whole process. Let’s

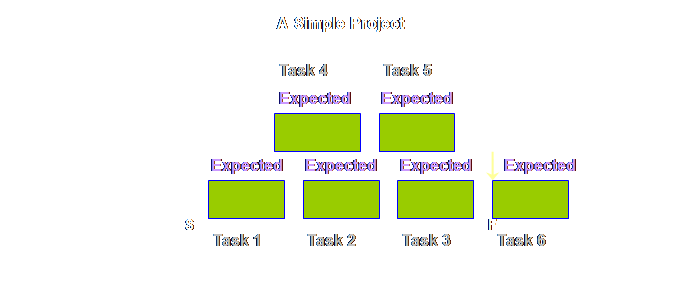

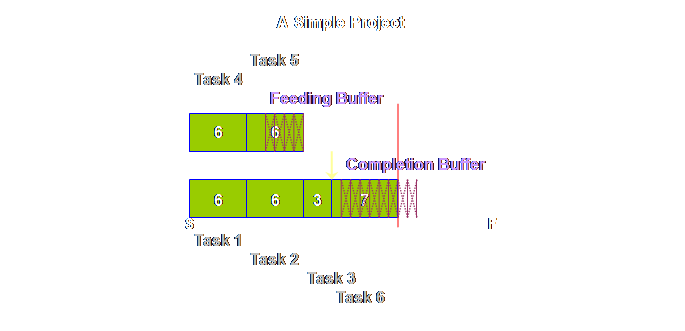

have a look.
What happens next is that because the touch time in
production operations is so small (remember we have drawn it here 1 to 5 to
10 times too large) it is ignored completely. This is what our process looks like as a
consequence.
What
then if we accept that we can move from a Critical Path schedule to a
Critical Chain sequence. The only
things scheduled being the start and the finish. If we accept that, then we can aggregate
the touch time and we can aggregate the safety time. By aggregating the safety time we make the
total safety time available to the whole process. Let’s

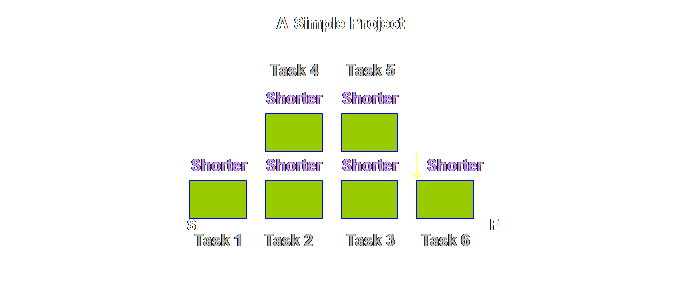

have a look.

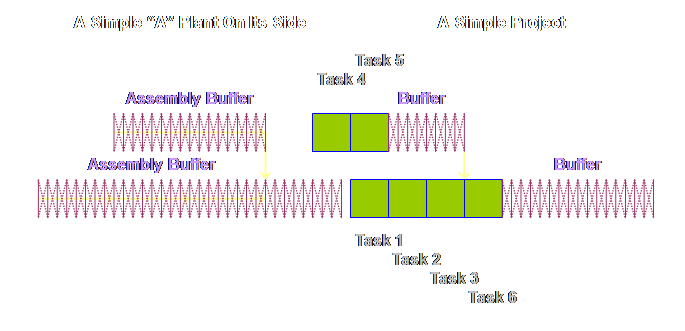

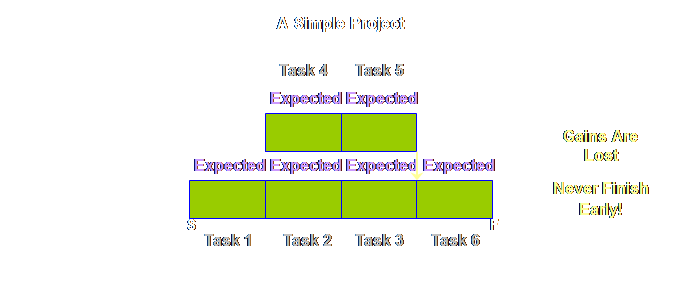

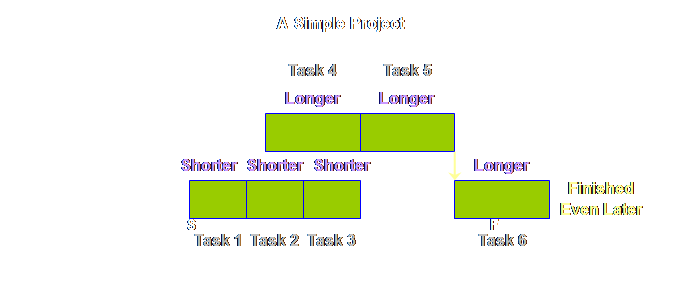

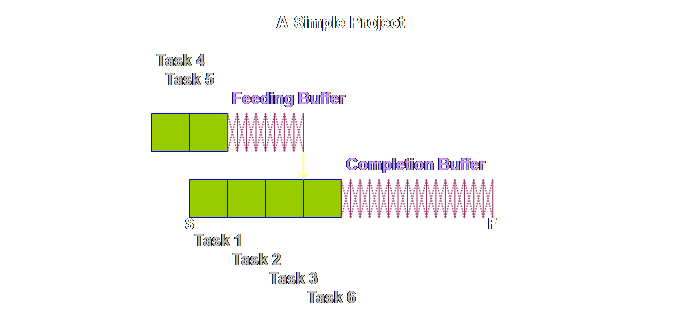

Having
made these changes, do you see the apparent difference between the two sets
of buffers? To me, the buffers in
production operations appeared to occupy the whole of the process. In project operations the buffers don’t
occupy the whole of the project, instead they appear to be bunched-up towards
the end. However, the reality rather
than the appearance is more important.
The reality is that the buffers in both cases are treated in exactly
the same way, the only difference is that in one of the cases, production
operations, we can make a simplifying assumption and remove the touch time
from contention. That is all that we
have done that is different. The
exact mechanics in each case are a little different from this simple
example. We have dealt with the production
operations case in detail in the production pages of this website, and we
will deal with the detail of project operations case over the remainder of
these project pages. Although the
detail may vary, the principle is the same (and in distribution and raw
material supply as well); we wish to identify and locate all the locally
distributed safety or waiting and aggregate it into one or several
strategically placed global buffers where the least total safety can be of
the greatest benefit to the system as a whole. If we can remove safety that is embedded
but wasted then we should be able shorten the duration of the project without
endangering the on-time reliability of the completion date. In fact, as we will see, we can
substantially improve the reliability of the completion date as a
consequence. First,
however, let’s consider a few more aspects of touch time and variability in
production operations and projects. The
touch time in production operations is a very small part of the total time
spent in the process; most of the time is, in fact, spent waiting. In addition to the touch time being a small
part of the total, there is also little variability in its duration. This isn’t so much a case of the repeatability
of the tasks, but rather the mechanization of the tasks – although, clearly,
the more often a task is repeated the more likely we are to want to mechanize
it. And if we can mechanize it, then
automation is the next logical step after that. There are without doubt some manufacturing
tasks which have greater variability in their touch time than others; those
that use natural products and those that use manual labor are the two that
spring to mind. However, even in these
cases the variability is still not large. So
where then is the variability in production operations? It is in the wait or queue time? In fact, it is an assertion. I can’t quantify the assertion because I
have never seen a graph of variability in wait time. There is genuine concern about the amount
of work-in-process and hence total wait time in a process, but little
interest in its variability between the same steps for the same product. Its an invisible attribute. What
then of projects? Let’s start at the
easy place. Variability in wait time
or safety time is said to not exist, because safety time is said not to
exist, or at least insufficient safety time is said to exist because some
tasks in projects, and certainly almost all whole projects, tend to be late
rather than on-time or even early. In
the first instance then, it is better to view a project as a mirror image of
a production process. All the
variability in a project appears to be in the touch time of the task. Why
should the touch time of a task be variable?
To answer that we have to look at two things; §
The nature of the task §
The nature of the resources (= people) Let’s
look at the nature of the task first, and let’s just limit ourselves for the
time being to the realization that sometimes the subject matter of the task unfolds
swimmingly well, and equally, sometimes it does not. Thus there is some natural variability even
if a particular task is well known and well practiced. How
about the nature of the resources then?
Just as in production operations, people add variability to a task as
well; people unlike machines have good days and bad days (although I know a
few machines that seemed to be able to mimic this attribute well). If someone has not done a specific task
before, or the task is significantly different from prior experience, then we
ought to expect greater variability.
The task may take less time, it may take more. People with a large amount of prior
experience (both explicit and tacit knowledge) might turn out less variable
results than someone who is new. Let’s
summarize this. There is variability around what is known Even if
we confine ourselves to what is known within the task of a project, then
there is variability. Because the
touch time is so large in proportion to the duration of the whole project, so
too, is the effect of any variability.
In production operations the task variability is small, the tasks are
small, and the shock absorbers for this, the in-queue waiting time, is huge. In project operations in contrast, the
tasks are large, the variability is therefore magnified, and the shock
absorbers are perceived to be small to non-existent. Let’s
confine ourselves for the moment to just this simple view of task
variation. It is naive I know, but if
we can understand the effects in this simple case, then the more complicated
issues caused by uncertainty will fall out as a consequence. We will address uncertainty, but not quite
yet. Let’s have a look at the effect
of variability on dependent tasks in a simple project. Common
sense would seem to suggest to us that variability in project tasks ought not
to be such a bad thing. Surely over a
number of tasks the variability should average out? Surely the larger the size of a project,
and the number of individual tasks, the more likely it is that the project
will come in on time as the over-runs and under-runs average out? If this
is our plan,
Sad, is
it not? But it gets worse. Let’s see.
Multiple
dependency at convergences have quite an impact, but there are also other
dependencies wherever there is a “hand-off” between two adjacent tasks. We might not like to think of them in the
same terms as the convergence, but alas, the mechanics are exactly the

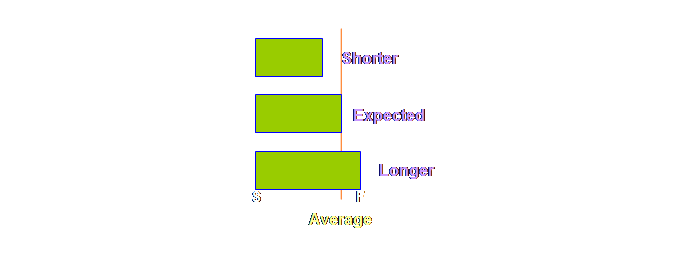

same. Let’s have a look. Let’s

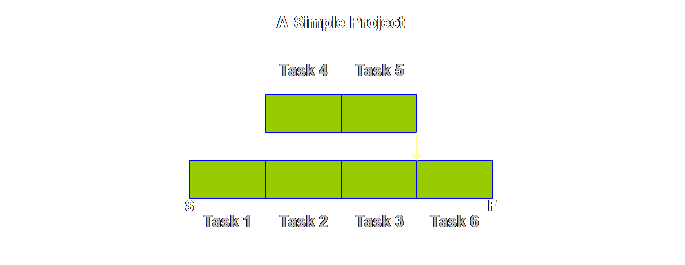

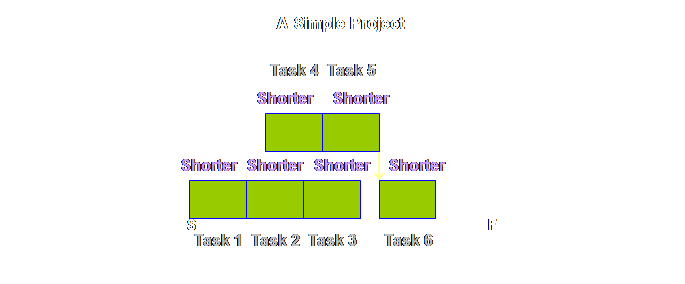

take an extreme example where all of the tasks are completed in a shorter
duration than the estimate. The whole
project should finish early – right?
If everything went swimmingly well then this is what we should
achieve.
The
reasons that we don’t get early starts to tasks and therefore early
completions of the whole project are manifold. Some are mechanical, some are psychological
(and real rather than imagined). Let’s
have a look at the mechanical aspects first.
If
those are the mechanical reasons (essentially people are busy), what are the
psychological reasons? The
psychological reasons belong more with the early finish of the preceding task
rather than the early start of the succeeding task. Ask yourself; how often have you seen a
task finish early? Probably not very
often. Note, I didn’t say ask how often
they do finish early, I asked how often do you actually see it. You don’t see it because it is hidden. It is hidden for a number reasons. In reality we see the following.
Why
would people choose to slow down their task rather than to complete it early? One sound reason would be to protect the
very valuable safety time that has been so hard fought for and won on
previous occasions and which painful experience tell us that we need more
often than we don’t need. To lose that
safety now would put further tasks in future projects in jeopardy and that is
not something people wish to do at all. The
combination of successor task resources not being ready to start early when
there is an early finish, and predecessor task resources not being willing to
jeopardize future safety by finishing early ensures that gains in individual tasks are lost and that whole projects never
finish early. It sounds like a
bold assertion, but I am willing to entertain any evidence to the contrary. But
this is only half the story. We have
only looked at the extreme of tasks that are shorter than the expected
duration and thus have early finishes.
What about the other direction?
What about tasks that are longer than the expected duration or those

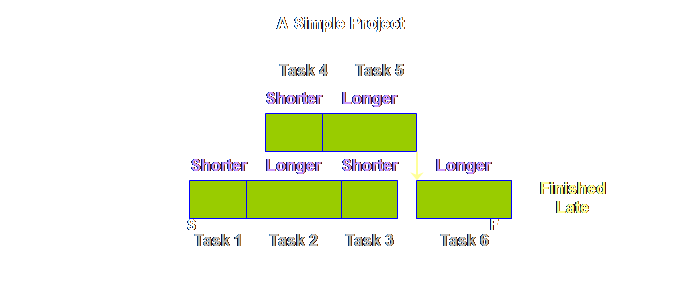

that have late starts? Let’s see. It’s not nice. We

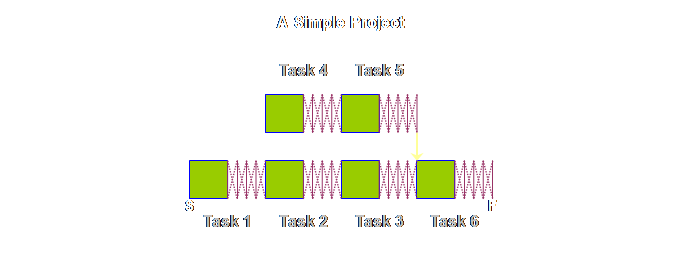

start once again with our simple project with our boringly uniform expected
durations and 6 simple tasks
How
about less legitimate reasons? Well,
like the early finish, we are unlikely to see such late starts recorded. Instead we are much more likely to see the
following.
Its a
sobering effect. We are just trying to
do our best, and yet it seems that at best our gains in individual tasks are

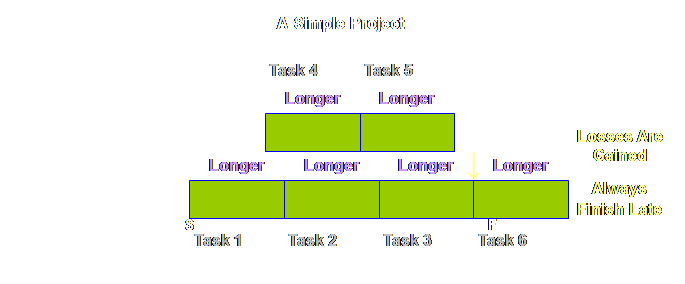

lost and whole projects will never finish early and at worst losses in individual tasks are gained and
whole projects will always finish late. Why do
we put up with this state of affairs? As we saw
earlier, shorter than estimated tasks can average out longer than estimated
tasks, and for that matter early finishes can average out late starts as
well. However, for a number of
mechanistic and psychological reasons this fails to happen. It fails to happen because safety is
embedded in each local task. If for
any reason we fail to utilize that safety it is lost to us for all time. If only the safety was available in-totality
somewhere to share out, rather than being embedded in each local task, then
surely we could resolve the mechanistic problems and maybe some of the
psychological ones too? The only way
to achieve this is to employ global buffering of the project. There is another reason why we must employ global buffering, an issue
that so far we have managed to avoid – uncertainty. So far
we have only looked at dependency in terms of how the completion of one task
affects the start of the next task.
Successor tasks are not only dependent upon the completion of the
predecessor tasks, they are also often contingent upon them. That is, the nature of the successor task
can not be fully determined until the uncertainty is resolved by the
predecessor task. This of course might
only unveil further uncertainty in the current task which is yet to be
quantified. For
example, a project that includes foundation earthworks might encounter more
difficult ground or easier ground than prior testing had indicated. Outdoor projects are often contingent upon
the weather. This must be factored
in. Any form of overhaul and
maintenance project is contingent upon the condition of the equipment as
found after stripping the equipment down.
While our local garage may be able to say “it will depend upon what we
find,” project-sized operations must make a reasonable allowance for such
things ahead of the fact. Contingent
dependency and therefore uncertainty are common factors in projects. What
happens the first time a pharmaceutical company makes its first scaling-up
experiments? A new recipe that works
perfectly in lab scale trials is moved for the first time to pre-production
trials. Sure the rigs are the same as
all the other pre-production trials and yet there is novelty in the current
mix. The chemistry, the quantities,
the order of mixing, the mixing itself, and the consequent “cooking” are all
new. Will the yield and the quality be
sufficient? If not, what needs to be
changed, and if there is a change, how many more trials until we can bring
the project to market? Where there is
novelty, there is uncertainty. In
fact, where there are unknowns, there is uncertainty. There
is one more major source of uncertainty.
Let’s have a look. In a
single project environment resources may not be dedicated solely to the
project tasks. In many small
businesses some people assigned to project tasks may also be assigned to
other non-project tasks that must be fulfilled, such as day-to-day business
or managerial functions. Such a case
is very common in smaller professional firms.
In many firms, both small and large, there may also be many concurrent
fee-earning projects each with its own needs and priorities. Some people assigned to project tasks may
be assigned to multiple tasks in different projects (and some non-project
ones as well). This would not be an
issue if each task could be carried out to completion before the next is
started. Reality is that staff must
chop and change – multi-task – between different projects according to ever
changing needs, priorities, and mis-synchronization. In fact, like fire-fighting in production
operations, we often laud such activity, even if it is to the detriment of
the individuals concerned – they get worn out – and the projects themselves –
they are always longer and later than we want. Uncertainty
is a dominant characteristic of project operations. If we
found that; There is variability around what is known Then we
must conclude that; There is uncertainty around what is unknown Unknowns
and the consequent uncertainty are a fact of life in project operations. How do we accommodate such
uncertainty? As it turns out, rather
well actually, lets see. Strange
as it may seem, it is very hard to find a novice production operation; even a
new firm on a “green fields” site that starts from scratch will endeavor to
employ people who have prior experience in the field, especially the detail
complexity of the specific endeavor.
Ditto, project operations. We
know uncertainty exists and we accommodate it by extending the duration of
the individual tasks. The more
uncertain we are, the more likely we are to seek longer task durations. The duration is weighed-up against prior
experience. Every task automatically
compensates or accommodates the uncertainty into the task estimate. The real issue, as with the case of simple
variation, is the existence of dependencies, and the local locking in of the
embedded safety. Greater
uncertainty simply compounds all the effects that we observed earlier due to
dependency – either mechanistic or psychological; any gains from individual
tasks are lost and projects simply don’t finish early. Moreover, any losses in individual tasks
are accumulated and projects finish later and later. This need not happen. There is more than adequate safety
allocated and embedded into each of the individual tasks. We

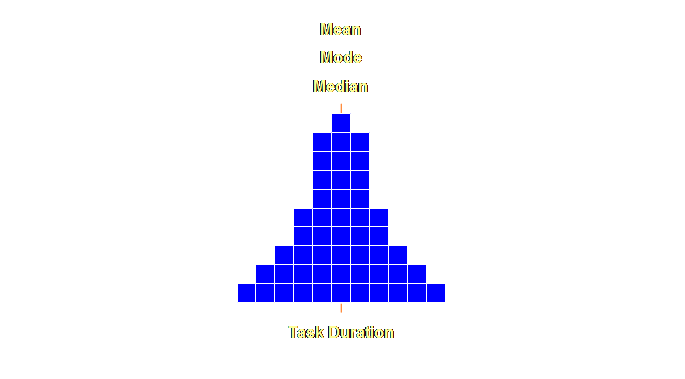

started our discussion on variability and dependent events with a simple
project where the under-runs and over-runs around an average task estimate
cancelled one another out and the overall effect was that the project
finished on time. This was based in
part on the notion that some sort of “normal” distribution is at work at the

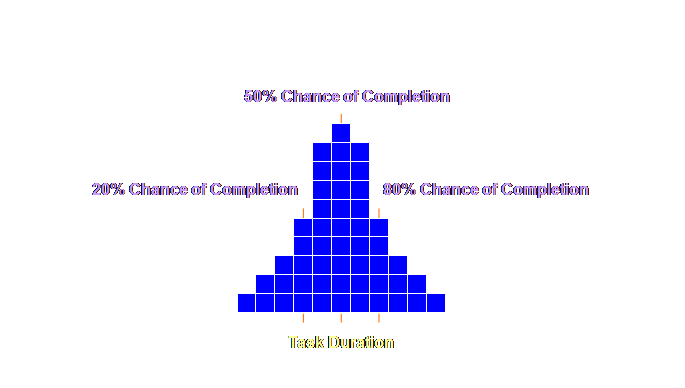

task duration level. Let’s
have a look at this.
Let’s

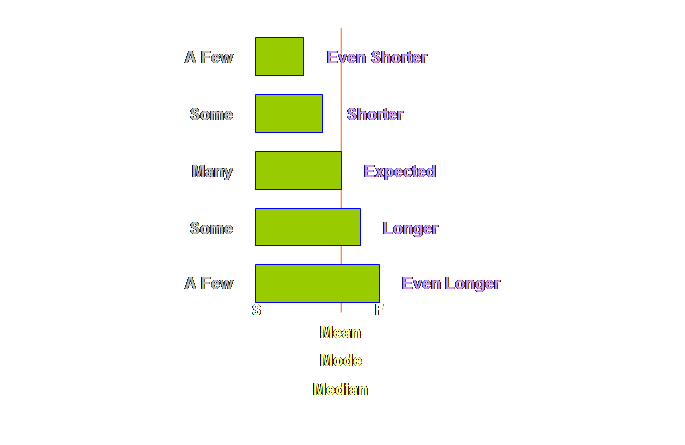

expand this out a little more, a few more extreme values at either end and
some quantitative estimates as well.
Let’s
have a look at this.
Let’s

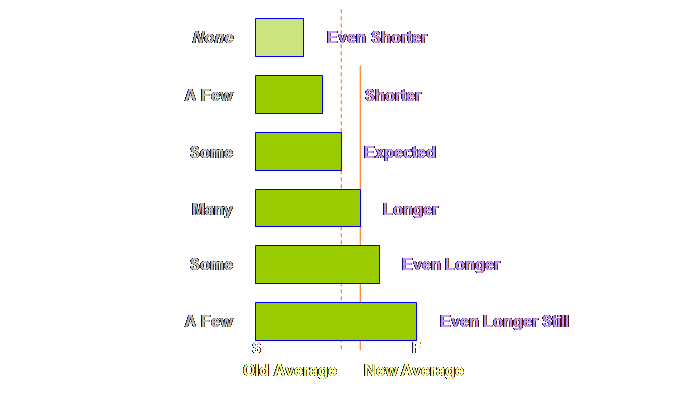

add some values to this distribution.

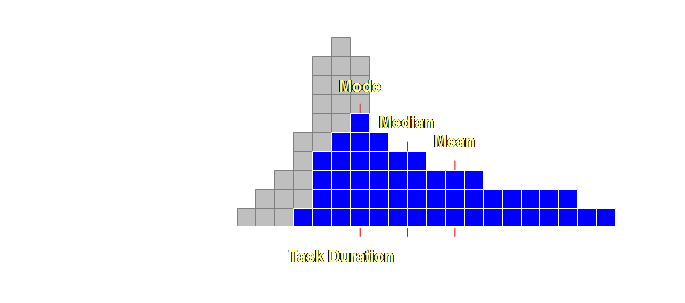

We
embed the necessary safety within each and every individual task duration
estimate. However, because this safety
is localized it is frequently wasted and our worst fears come true (again);
the overall project will not be completed on time. We view this as a vicious cycle of a
never-ending need for greater and greater safety estimates within the task
duration. If we
could make this localized safety accessible for any and all tasks within the
project by using buffers, then we would actually need less safety overall and
yet still finish on time. We need to
know how to access this safety, where to put it, and how much. These are essentially our task and buffer
sizing rules. Let’s have a look. Buffer
sizing for projects, as for production operations, is based upon a rule of
thumb, a heuristic if that sounds better.
It is based upon a rule of thumb because this has been found to be
thoroughly effective over a very wide range of scope and scale of project
management – from the maintenance of jumbo sized commercial aircraft to the
product development of the tiny hard drives in our computers (5). Remember we are after effective and
implementable solutions; we don’t want ineffective nor un-implementable
solutions; the world is awash with those already. Let’s
have a look at the rule. We take
our initial project plan,
By
halving the task duration we bring it back to something around the 50%
level. Then we will further protect
this with adequate buffers. This is
ample sufficiency as we will see. The
over-runs and under-runs around this estimate will average out due to the
placement of the buffers. Moreover,
halving the task duration has an important psychological effect that must not
be underestimated in its overall importance.
It stops the waste of unreported early finishes – because there is
precious little time to waste – and it stops the procrastination that causes
late starts – for the very same reason. Some
terminology. This shortened task time
has a number of names, it has been called the “trimmed task time” (4), “best estimate” or “50% probable” (6). It is also referred to as the “50%
estimate,” the “focused task time,” and the “reduced task time.” Take your pick. The
reason that there is more than ample sufficiency for individual tasks even at
the 50% estimate is because we
aggregate the other half of the task, our safety, at the end of the tasks
were it is accessible to all of the preceding tasks. Let’s
show this.
Again,
we have some new terminology. The
buffer on the critical chain was initially called the “project buffer” (4)
and this terminology has continued to be used in a number of sources. However, a second term is also in use, that
of “completion buffer” (7). Once again
you can take your pick, however, here we will be using “completion buffers”
because that is what we are buffering and it is good to constantly remind
people on projects that the project will be completed within the completion
buffer – the term is self-reinforcing.
The feeding chains that arise parallel to the critical chain are
uniformly called “feeding buffers.” It is probably
better to keep the name “project buffer” as the name of the class, and
“completion buffer” and “feeding buffer” as members of the class, just as
buffers in production operations consist of drum buffers, assembly buffers,
and shipping buffers. Returning

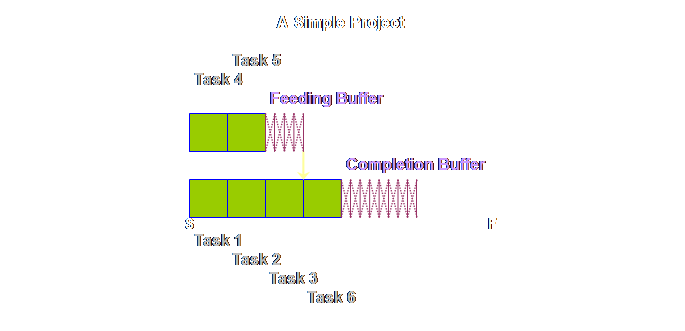

to the detail of our simple project above, once again we find that tasks 4
& 5 are pushed back and that this has increased the total length of the
project. However, this is just an
intermediate step. Because the local
safety is now aggregated and located in just a few strategic places, it will
be better utilized, and we need less in total than we had before. The

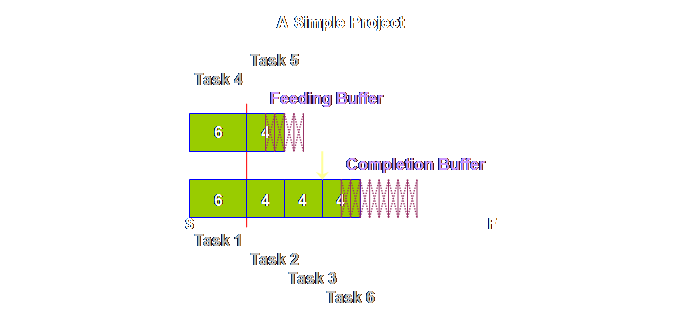

rule is that we need only half as much aggregated buffer as we did as prior non-aggregated
safety. Therefore we must halve the

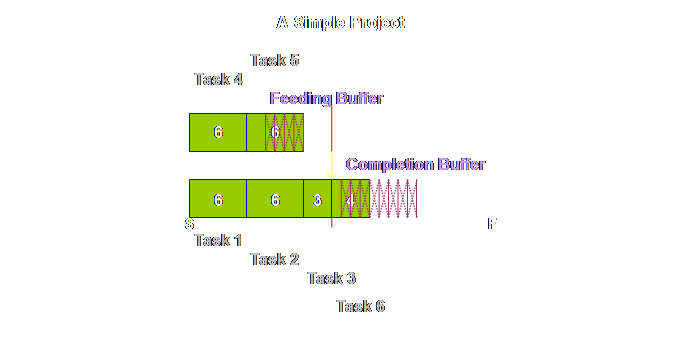

buffers (4). Let’s
see what this gives us.
Looking
at it another way, our new project duration is made up of 2/3rd’s task and
1/3rd buffer. And this leads us to a more
generic buffer sizing rule. Regardless
of the task sizing rule that is used, the buffers must be 50% of the task estimate. The “completion buffer is 1/2 of the lead
time of the (trimmed) project” (7). Take
care to note; we now have a sequence, not a schedule. Tasks 1, 2, 3, 4, and 6 are squashed up on
the left; this doesn’t mean each task is expected to be finished in the time
allocated to each task, nor that each will start immediately after the
preceding one. Instead we still expect
the normal range of variation that we have experienced up until now, but that
that variation will be accommodated from the global buffers It’s
taken us a long time to get here but I hope that it was worth it. Before
we finish however, let’s work through a project using our new found

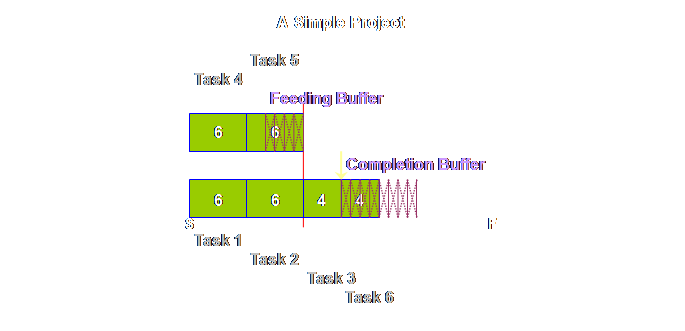

knowledge. Here is the project plan or
sequence. We have added a some numbers
to make it a little more clear how the plan progresses.
|
